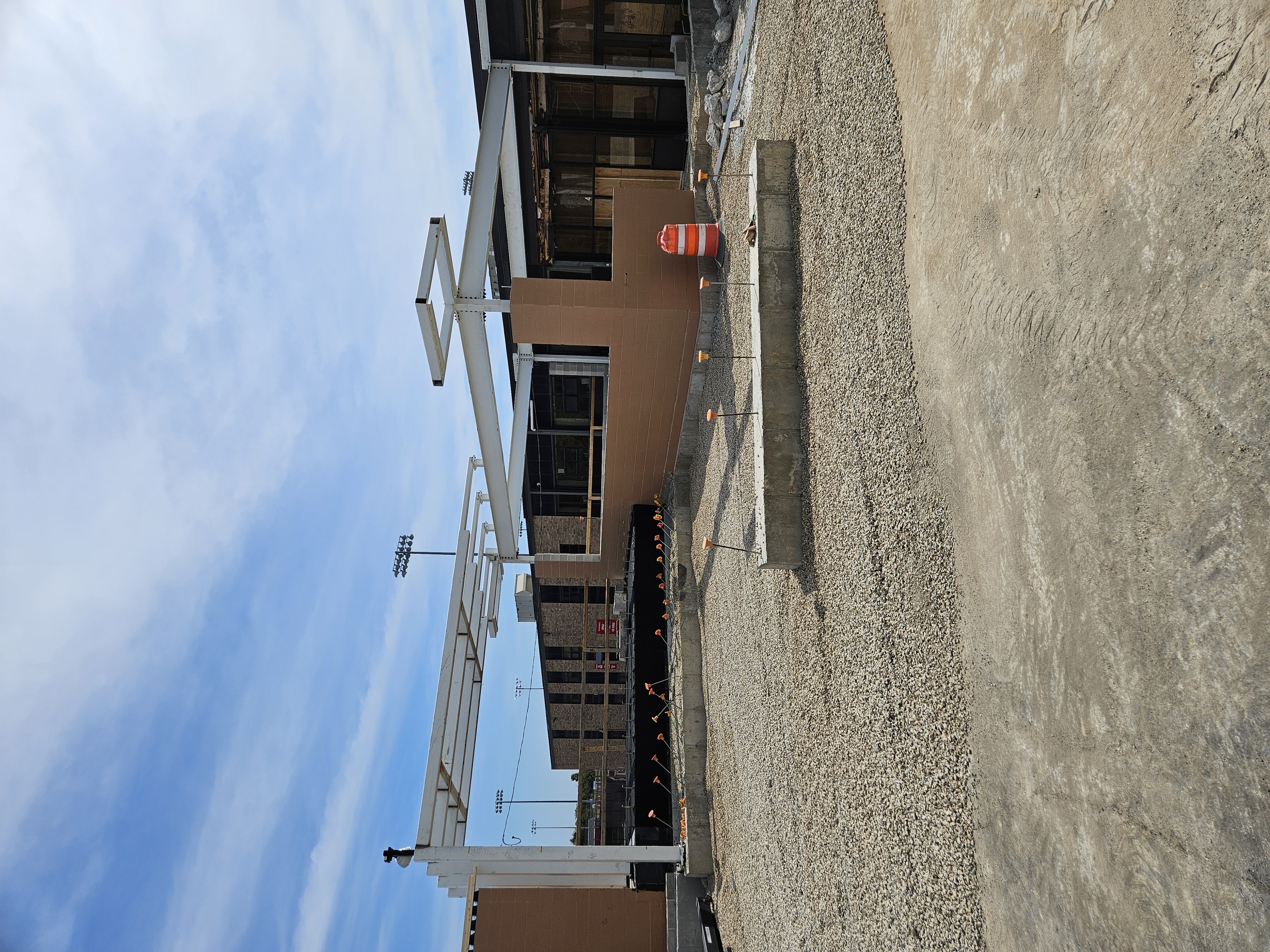

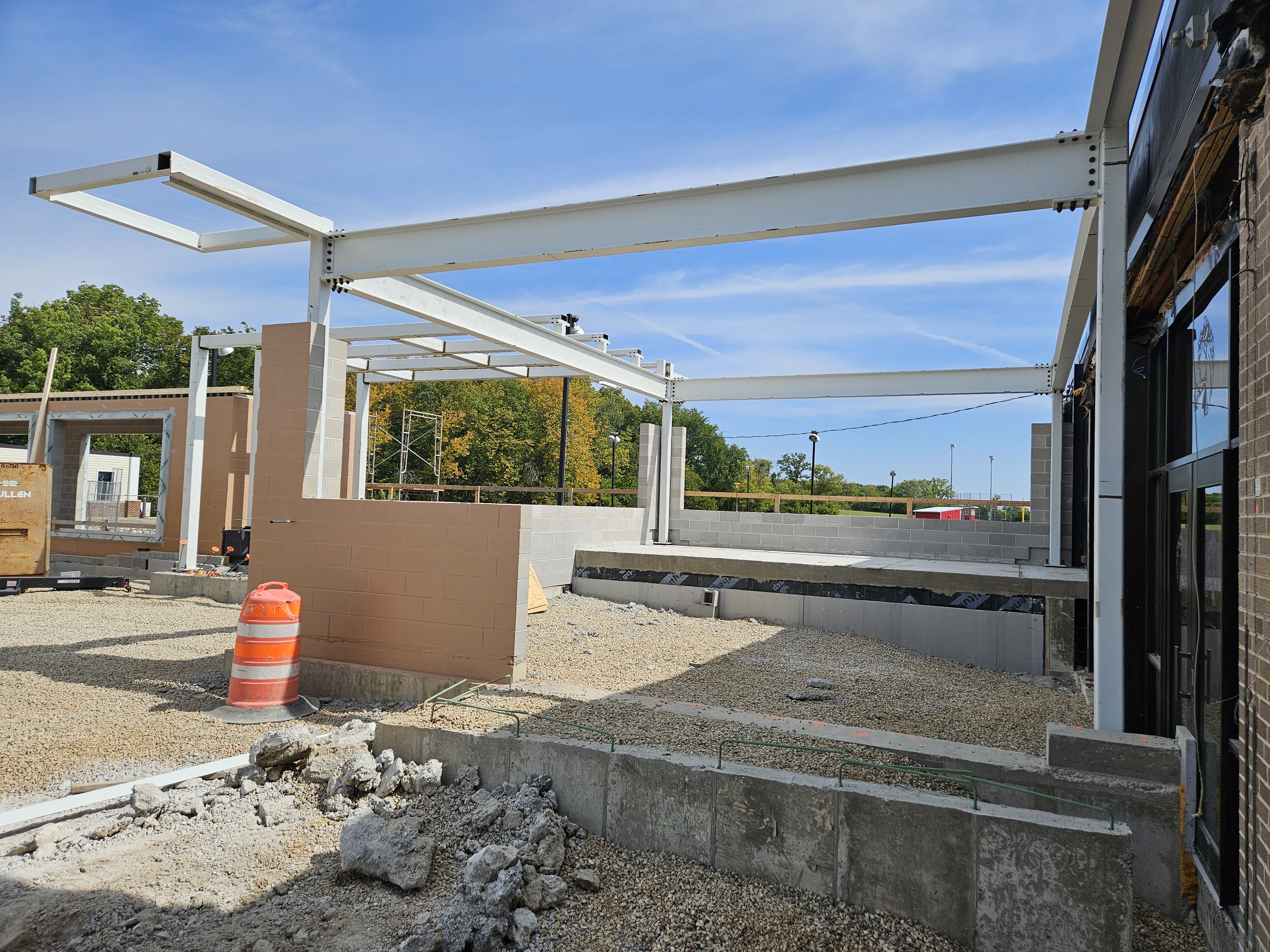

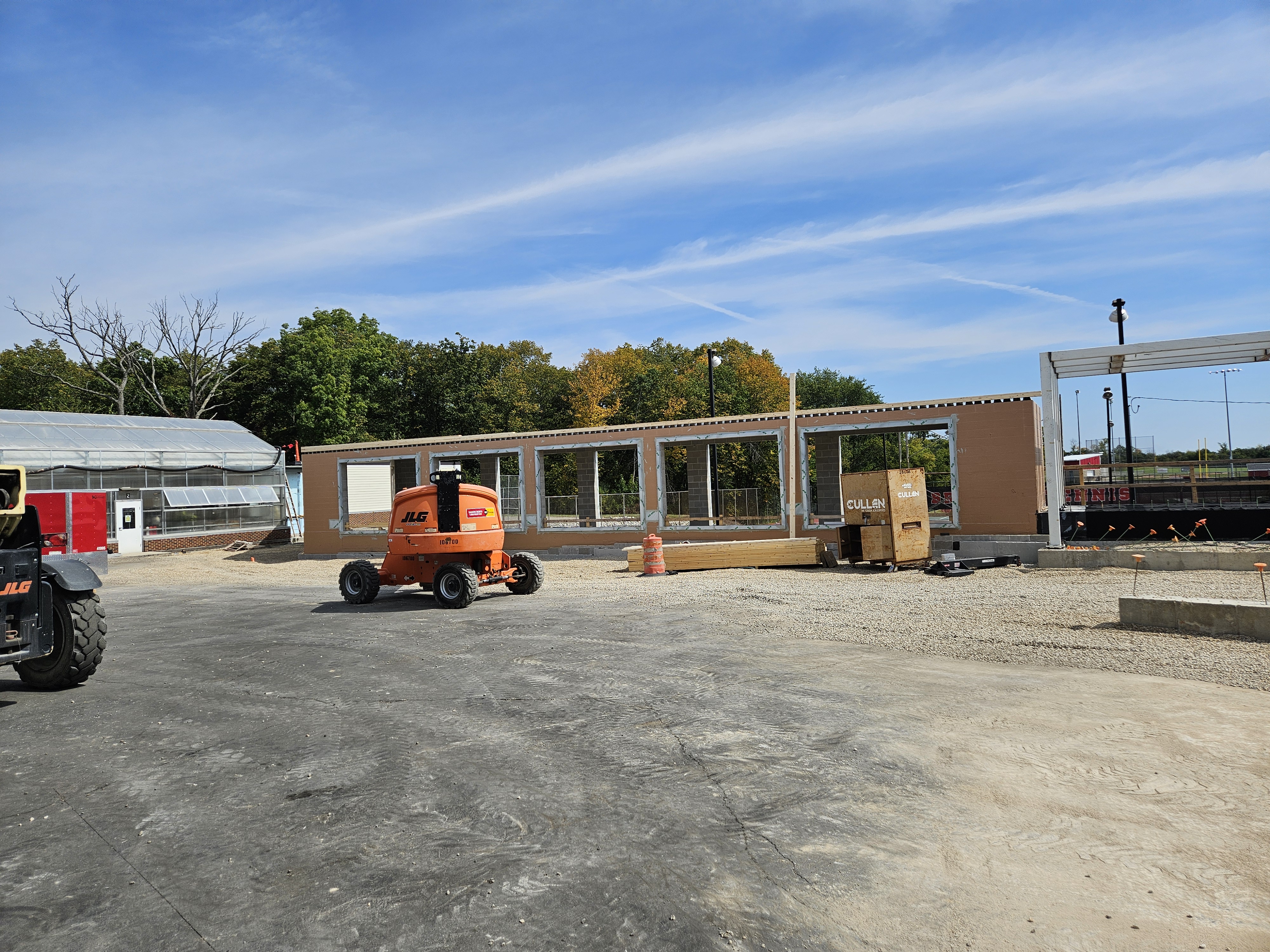

North Entrance & Corridor
Installation of CMU walls is complete, with the exception of the tie-in to the existing building. Structural steel erection is finished, and welding of the steel pergola has been successfully completed. Decking operations are scheduled to begin shortly. Application of the air and vapor barrier is currently in progress. The structural slab for the first-floor tunnel has been waterproofed.

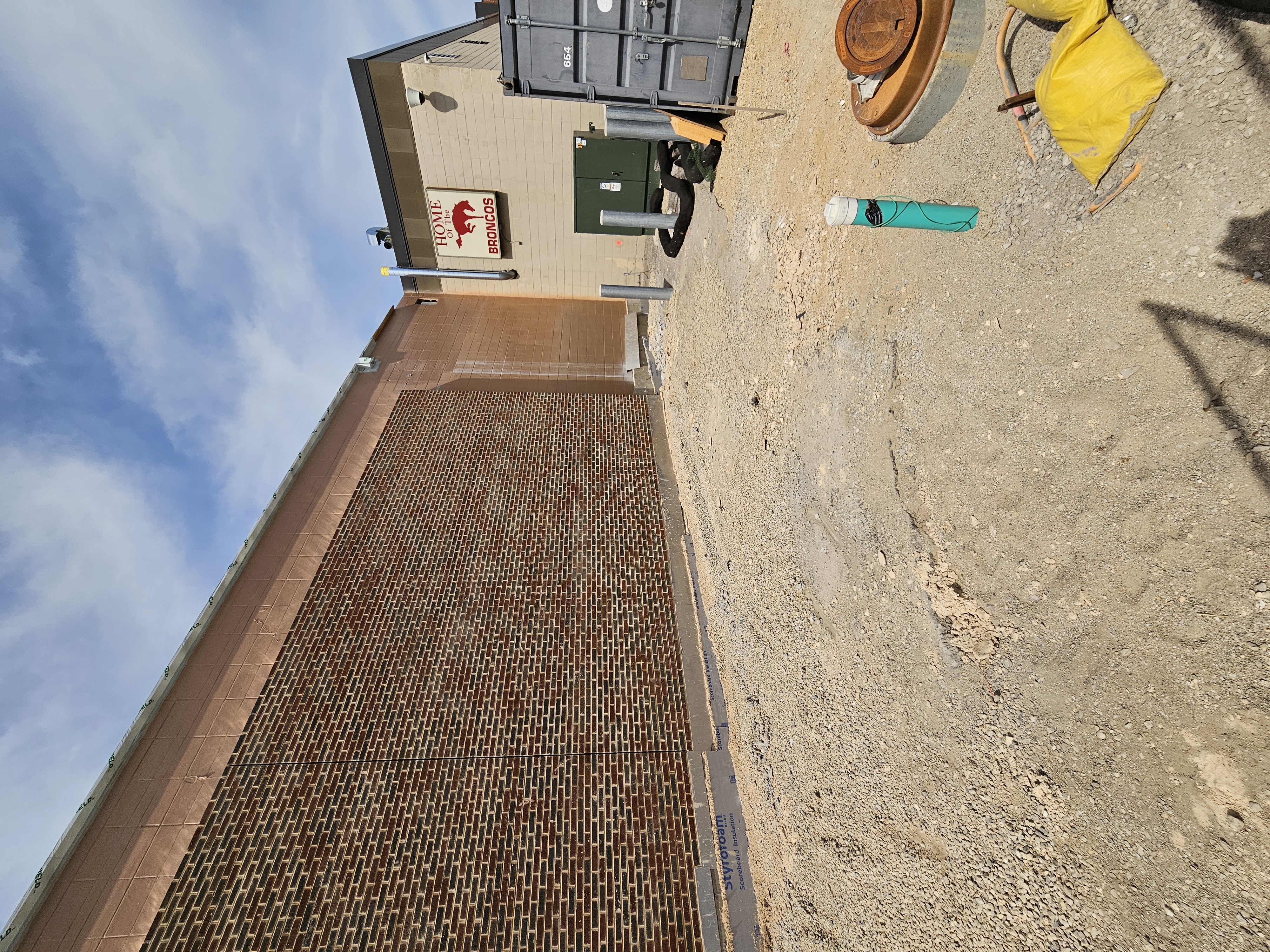

Tech Ed Addition

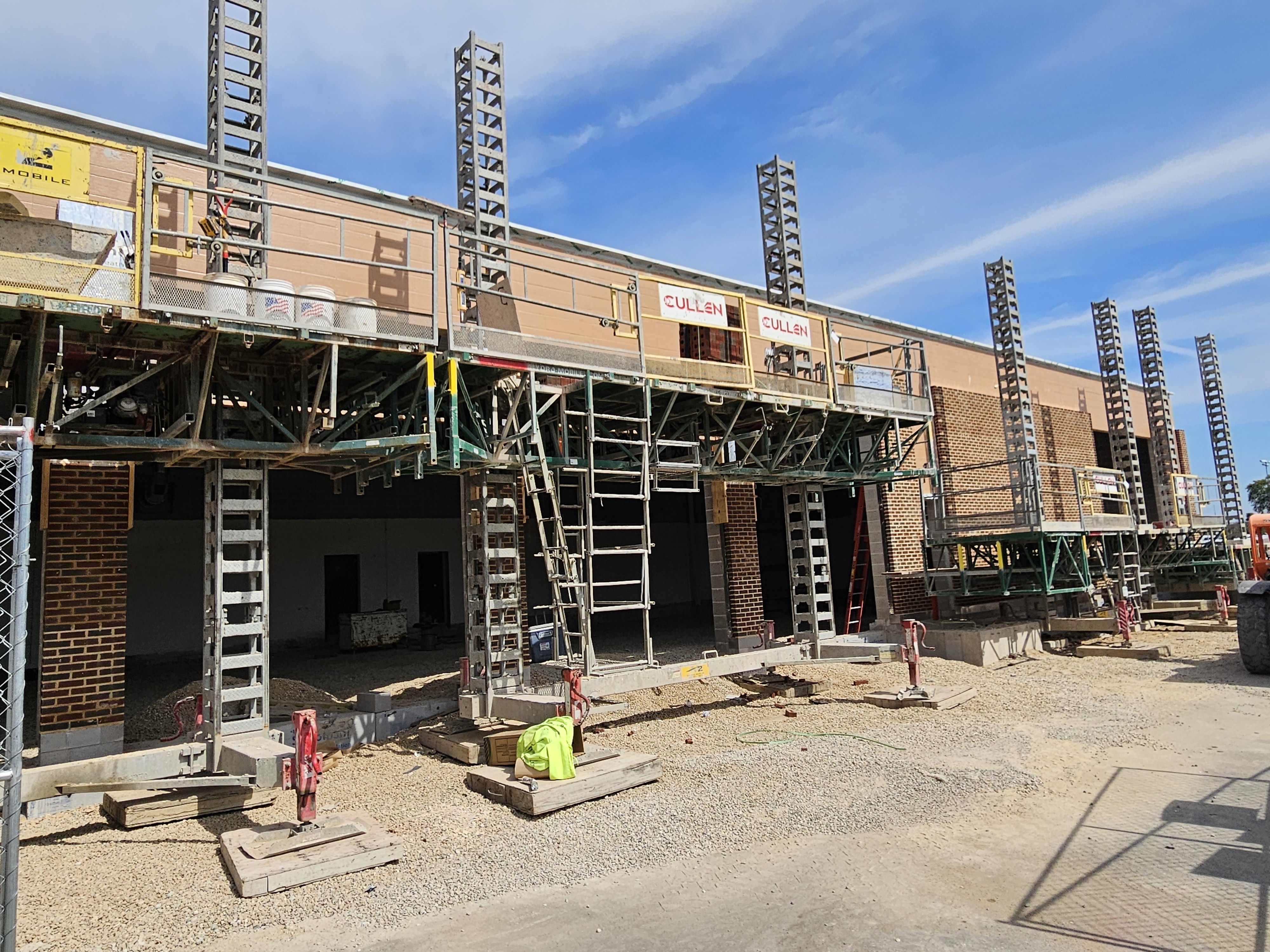

Brickwork is complete on both the east and west elevations. The remaining wall surfaces will be clad in metal panels. Masonry work on the south elevation is nearing completion, after which the masonry crew will transition to work on the North Connector.

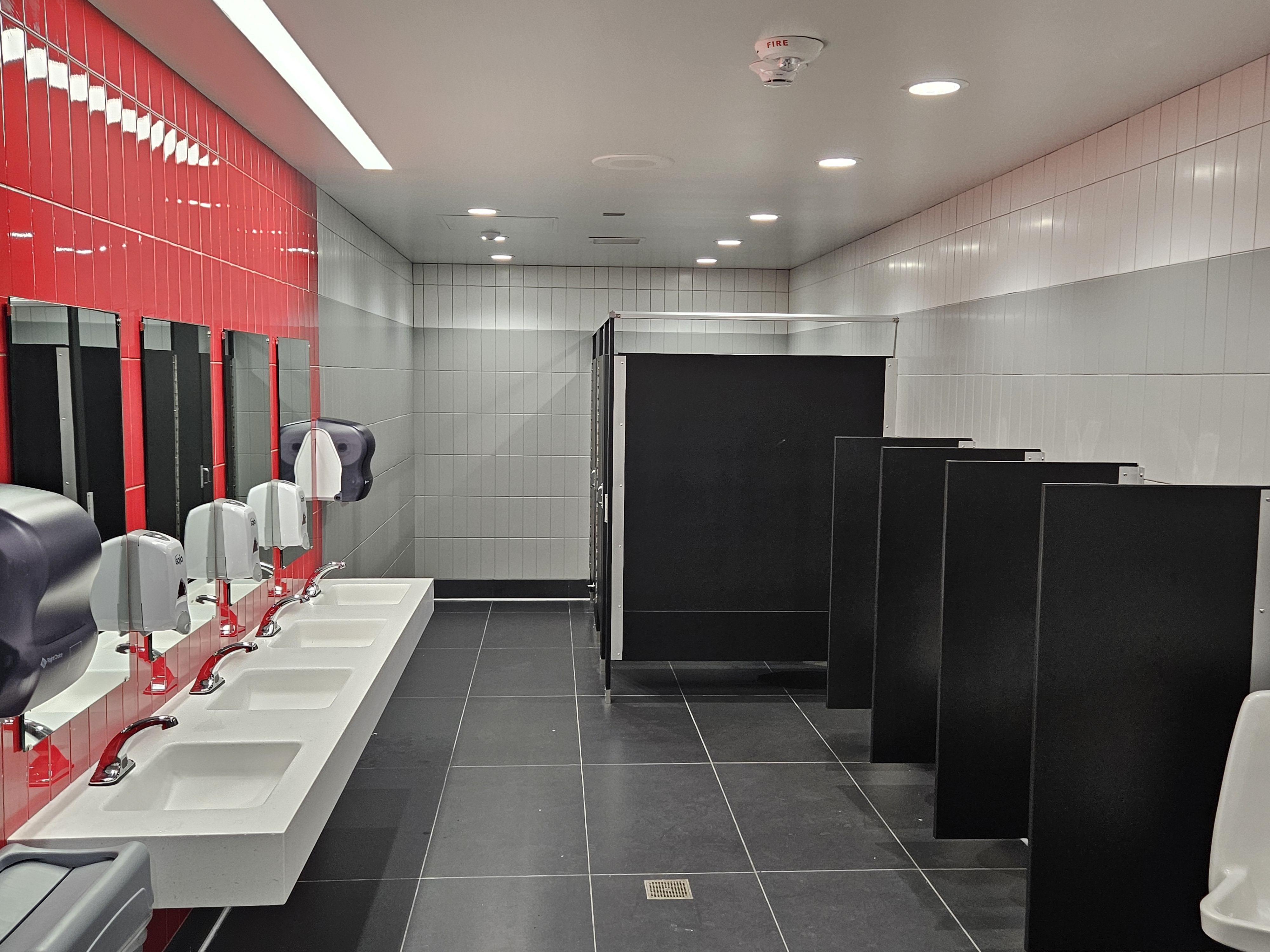

Bathrooms
Twelve of the bathrooms are completed!

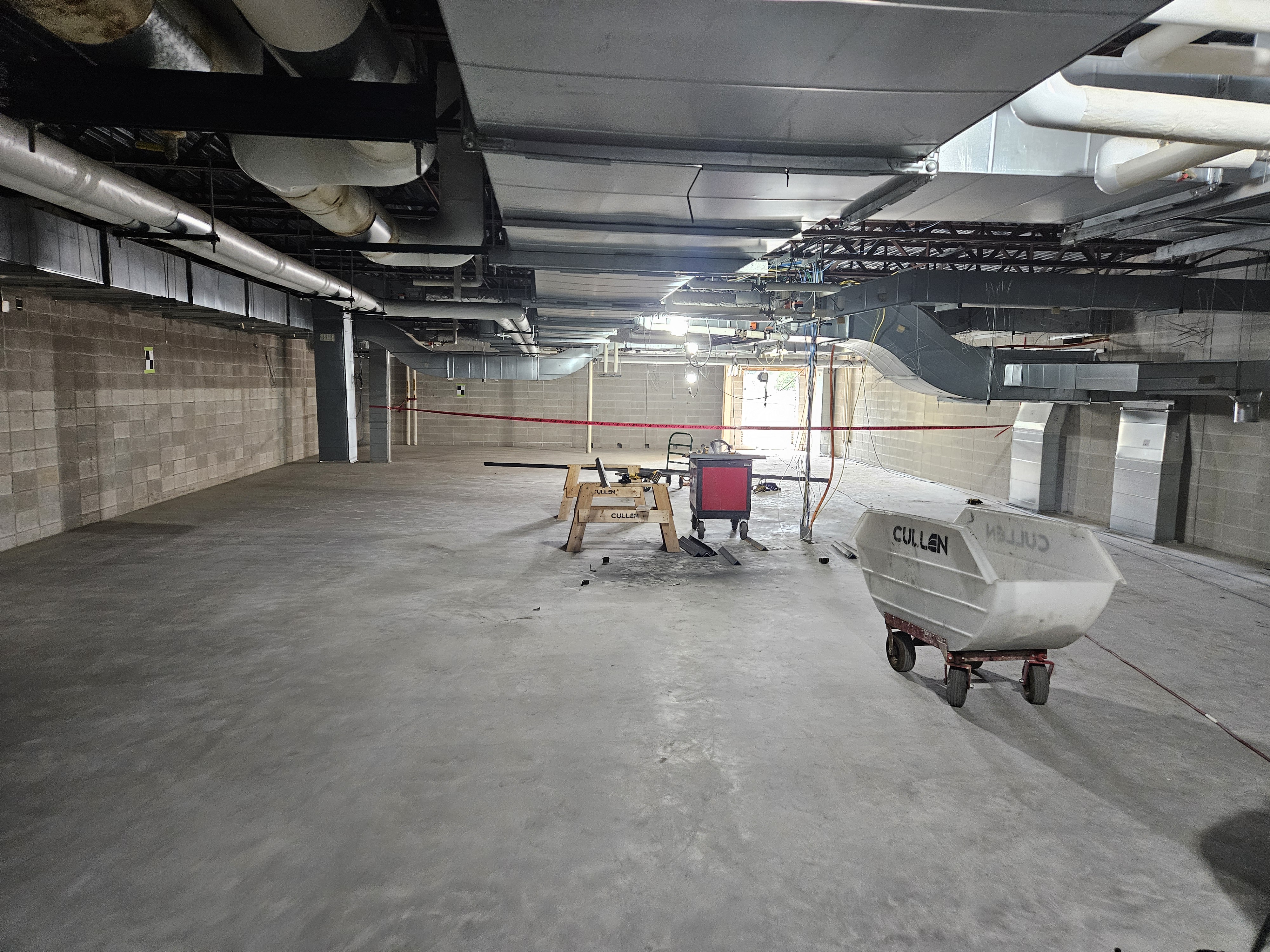

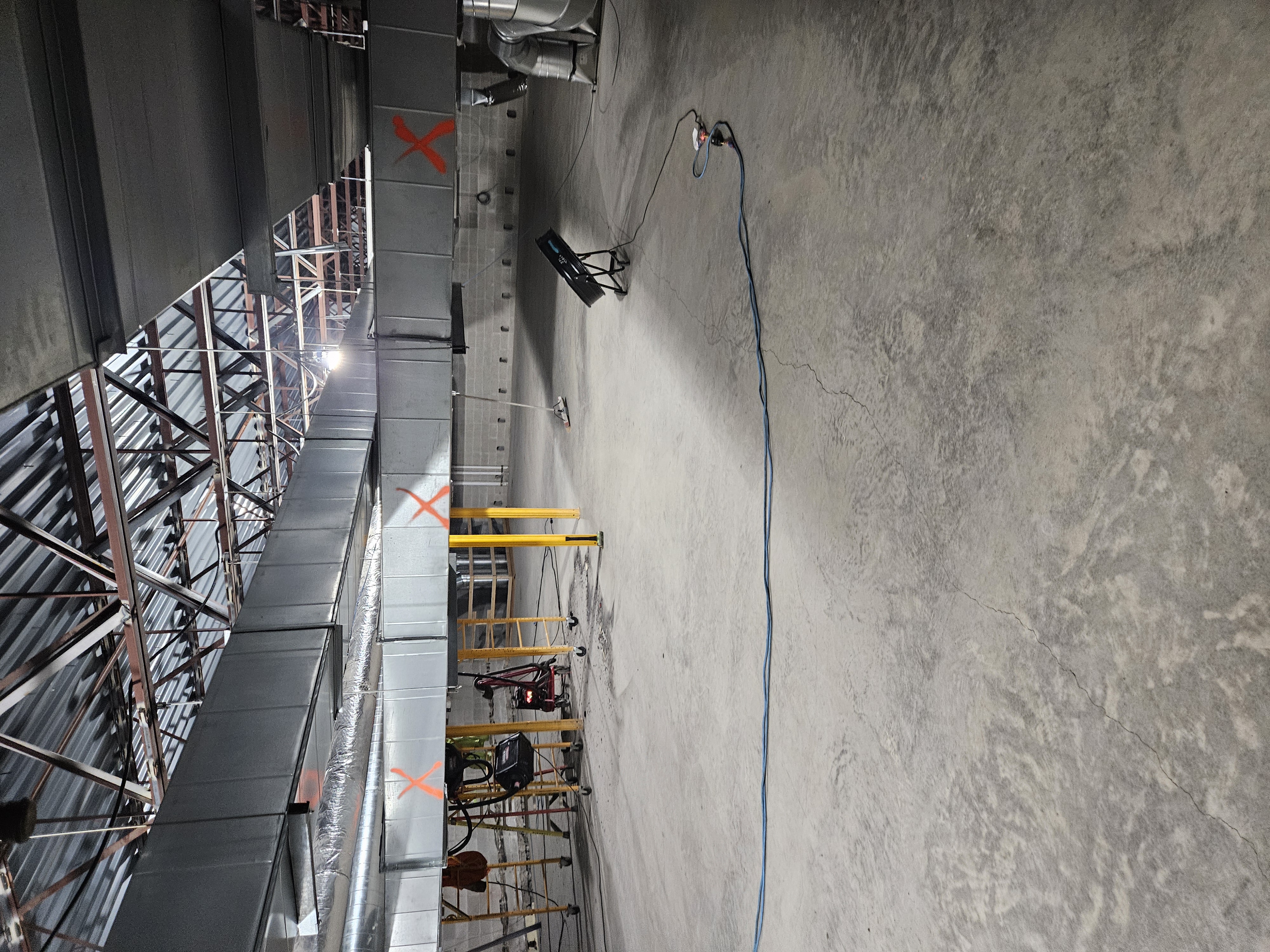

Science Expansion
HVAC is being rerouted, allowing for construction of the science classrooms.
